Chemical Plant Gyp Stack Closure

by

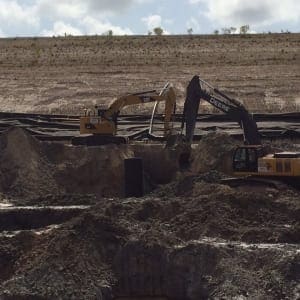

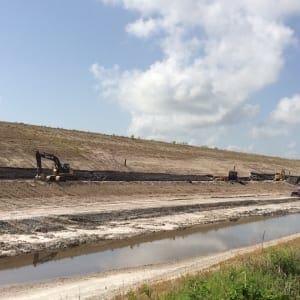

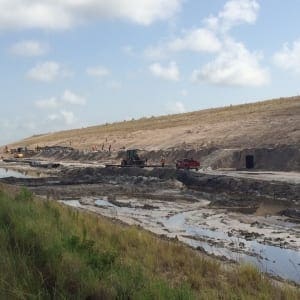

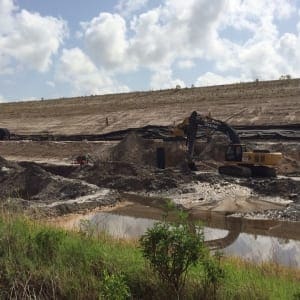

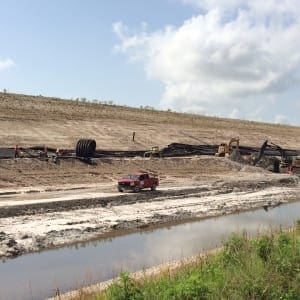

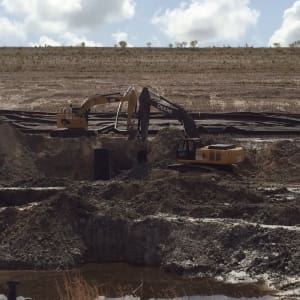

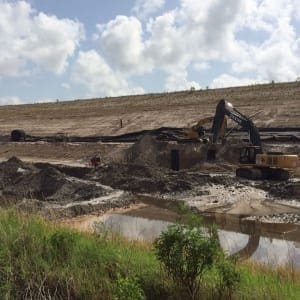

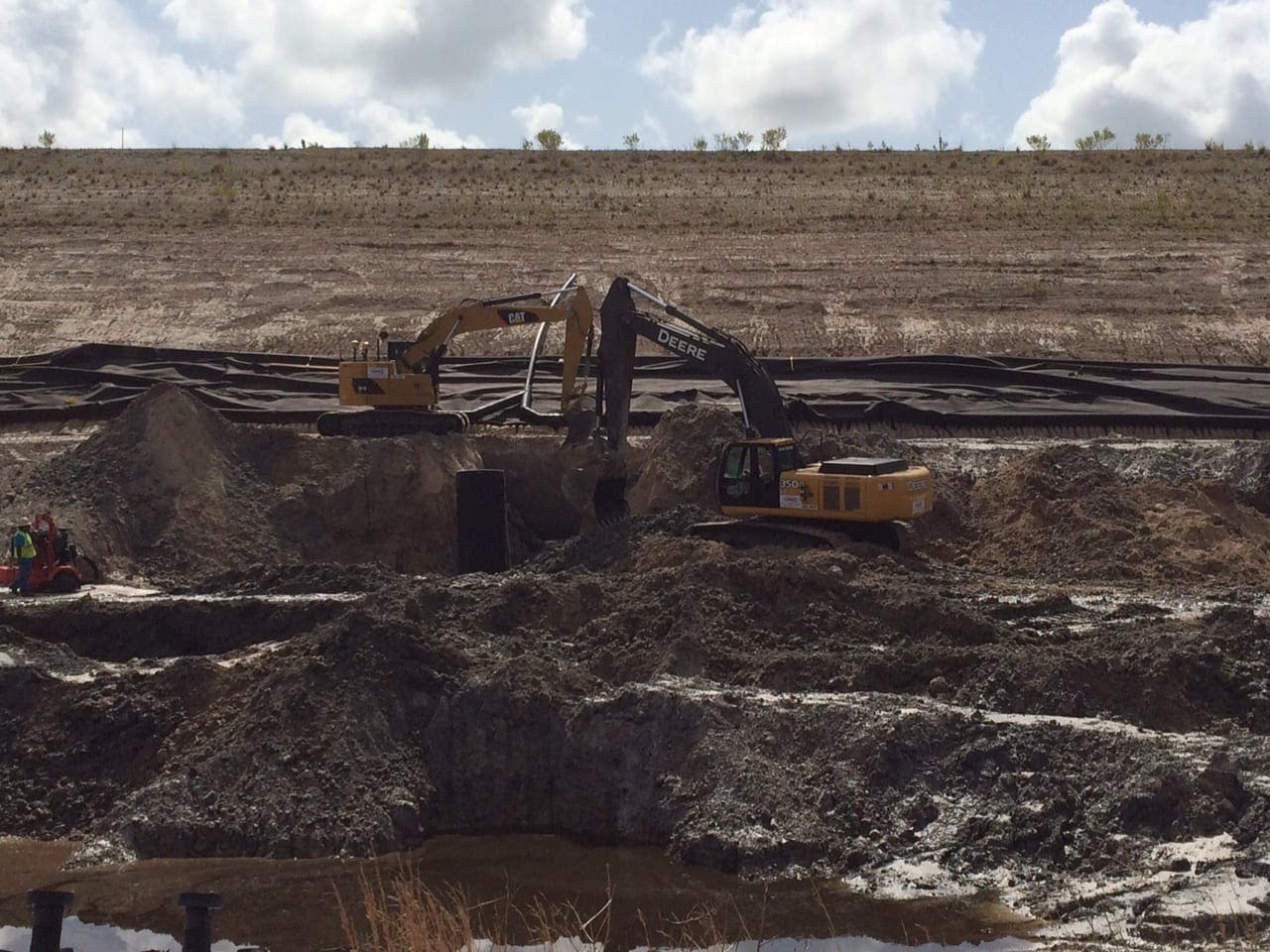

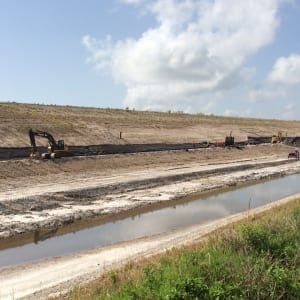

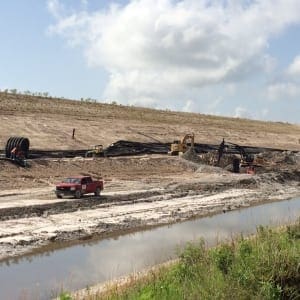

A COMANCO crew is rounding the corner of a gyp stack closure project at a chemical plant in Florida. The 24″ header installation is about halfway complete (5,600 LF installed), and the 12″ corrugated lower drain system is nearing 3,000 LF installed. There are also nine 48″ manholes installed along the south, west, and north sides of the gyp stack. Work is expected to be complete by the end of the year.
